Walter Preston Court

The Project was fully managed by Redbridge & Sons Property services as the principal contractor. The project was delivered on time and within budget.

Walter Preston Court is one of the Council’s many sheltered housing schemes, comprising 34 one-bedroom and two-bedroom apartments over two floors, run by Stroud District Council. With an aging heating system (approximately 35 years old), the objective was to improve the energy performance and condition of the heating and hot water services by fully upgrading the building’s mechanical plant and electrical infrastructure. This upgrade included the installation of new boilers and associated equipment, building management controls, and nine Grundfos circulation pumps, Magna 3 and Magna 3D types, both single and twin head versions.

Figure-1, Schedule of Circulation Pumps

Qty Heads Operation
3 Twinset Variable temperature pumps
1 Single HWS to the secondary
2 Twinset Primary domestic hot water pumps feeding hot water to heat exchangers
1 Twinset Primary heating pump feeding a buffer tank
2 Single Shunt pumps feeding each boiler

Given the sensitivity of the project, particularly the requirement to maintain heating and hot water services for its duration, temporary plant provided alternative means of heating and hot water. This setup ensured these services were maintained with minimal downtime over the 8-week completion period, 2-weeks shorter than the client allowed. A seamless switchover to the new system upon project completion was facilitated with new gate valves installed, providing ease of access and uninterrupted service for future pump replacements and maintenance, and especially the wet side of the system for showering and bathing.

With the plantroom located within the heart of the building adjacent to communal corridors and areas for dining and relaxing, working within a building that’s heavily occupied 24/7 required considered health and safety planning and liaison. Preconstruction proved a critical phase to minimise potential disruption and ensured that all technical and logistical aspects were addressed before the actual installation began.

Restart Phase

This phase emphasised a thorough risk assessment and the development of detailed method statements, ensuring a smooth and efficient transition from the old heating system to the new one, with a primary focus on resident wellbeing and minimising disruptions, deliveries, and traffic movements. The initial step involved a comprehensive risk assessment to identify potential hazards and challenges. Key focus areas included:

  • Resident wellbeing – Identifying risks such as noise, dust, and temporary loss of heating and hot water. Measures were planned to ensure residents’ comfort and safety throughout the project
  • Service disruption – Assessing the risk of downtime in heating and hot water services and developing strategies to mitigate this, such as using temporary plant equipment
  • Traffic and delivery management – Evaluating the impact of traffic and deliveries on residents and the local area. We implemented van sharing to minimise traffic movements and organised just in time deliveries coordinated to each phase of the project.

We subsequently prepared detailed method statements, outlining step-by-step procedures for each aspect of the installations. Key elements included:

  • Scope of work – Description of tasks, including removal of the old heating system, installation of new boilers and circulation pumps, and upgrading the electrical infrastructure
  • Safety procedures – Safety protocols to protect residents and workers, including the use of personal protective equipment (PPE), safe handling of materials, emergency preparedness and separating work areas from public areas while maintaining safe access in and out of the building from reviewing fire and evacuation management plans.
  • Minimising disruption – Instructions for scheduling work to minimise noise and other disruptions, and being proactive in our communication where noisy works and some disruptions were unavoidable
  • Traffic management – Procedures for managing traffic and deliveries, including scheduling deliveries outside peak hours
  • Site waste management – A site waste management plan guided arrangements for waste reduction, and diversion from land fill

Stakeholder Communication

Effective communication with all stakeholders was crucial. We held regular meetings with local staff to discuss progress and critical phases of the work. We informed residents on project progress via noticeboards and letter drops placed under their front doors.

Procurement and Logistics

Effective communication with all stakeholders was crucial. We held regular meetings with local staff to discuss progress and critical phases of the work. We informed residents on project progress via noticeboards and letter drops placed under their front doors.

Installation Phase

We led and delivered the project via our own professionally qualified mechanical engineers and electrician, with subcontracted support for flue installations and to install the new building management system.

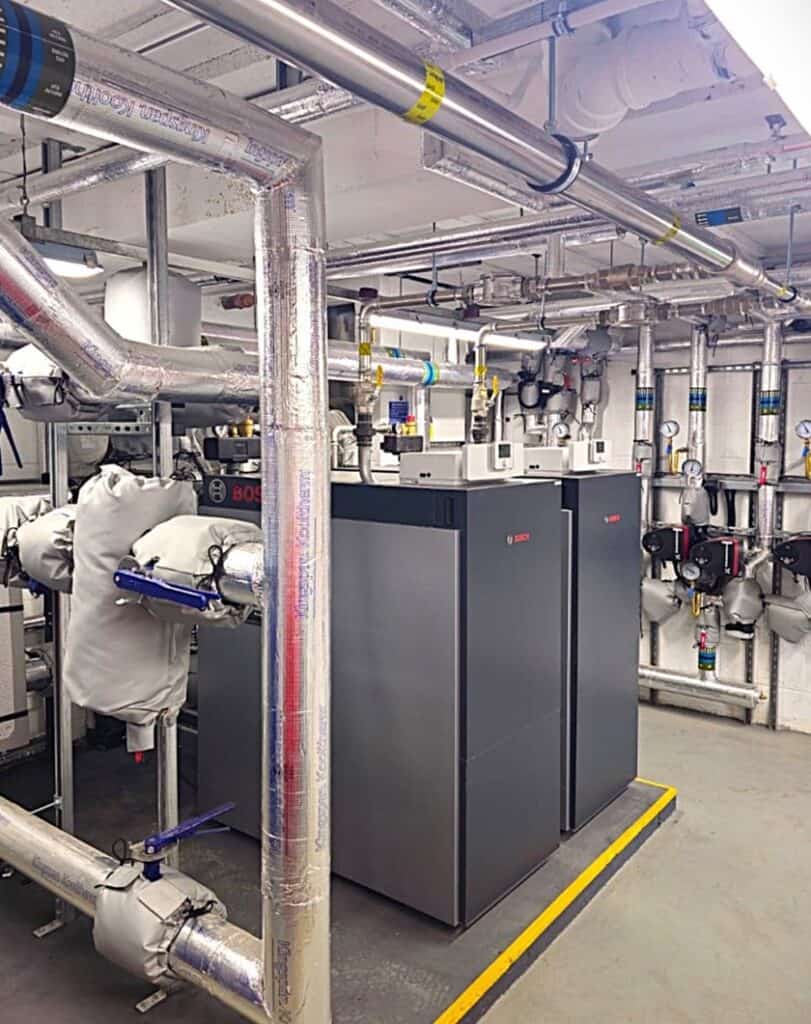

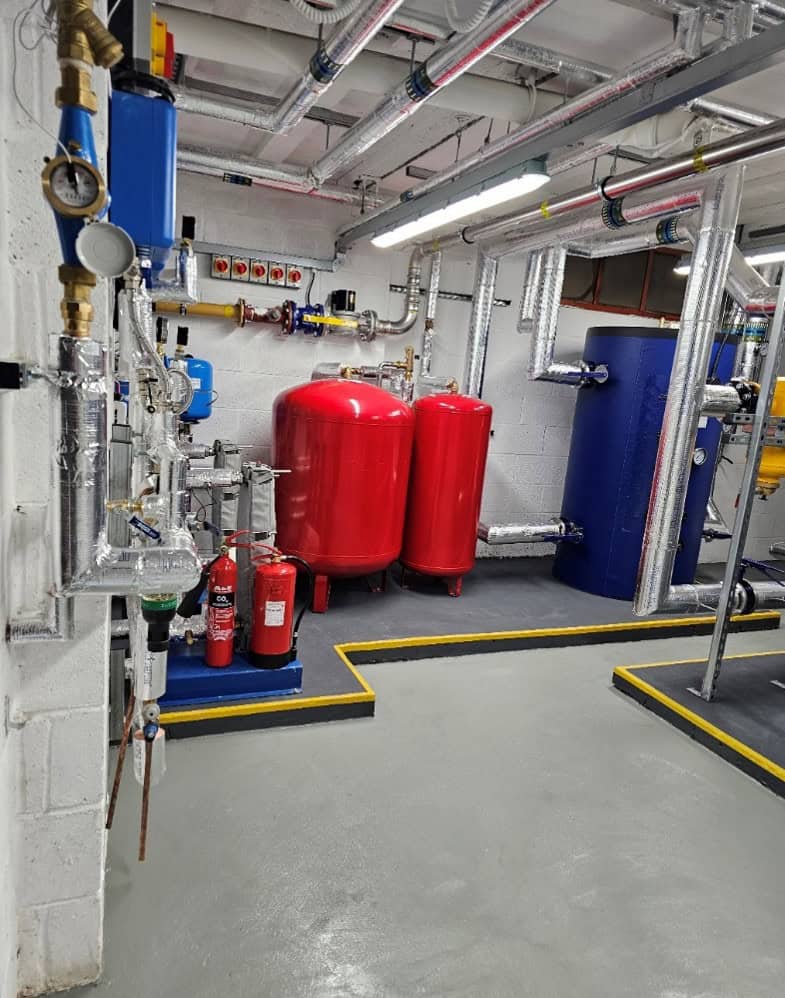

The process began by safely decommissioning the old heating system and installing a temporary plant to maintain heating and hot water services with minimal disruption to residents. The new energy-efficient boilers, Grundfos circulation pumps, and advanced building management controls were then installed, complete with minor builders works to make good followed by passive fire protection to seal service penetrations where required.

Comprehensive testing and commissioning ensured that all components functioned correctly, and the system was balanced for optimal performance and resident comfort. A seamless switchover from the temporary plant to the new heating system was achieved with seamlessly without downtime, facilitated by the installation of new gate valves. Throughout the process, residents were kept informed, and their feedback was collected to ensure satisfaction. The final handover included training and instruction how to operate the new system.

Why Choose Redbridge For Your Solar PV?

Experts In Renewable Energy

Expertise and Experience

Trusted Renewable Energy Specialists

Quality Products

Renewable Energy Specialists

Proven Track Record

Bespoke Solar Pen installations

Customised Solutions

Need Help?

We would love to talk to you more about solar panels, and the benefits they can have on your electricity bill, contact us today to get the best deals.

In a word, No.

We can fit panels on to a roof or roof’s that face SE, SW or have a East and West split, for example if your garden is North or South facing, but the roof of your house faces to either side we would install panels on both sides of the roof. Whilst the best results do come from a South facing roof, we can achieve in exces of 80% of a South facing yield by fitting to other orientations.

Solar Panels can be fitted to your flat or sloping roof or in your garden. We fit high output panels to maximise the generation per square metre of roof you have available meaning we can achieve over 2kW of power from a small 6 panel system, most properties have the roof capacity for at least 6 panels, and many have considerably more capabilities for power generation (especially bungalows).

Yes, Solar Panels work in all daylight conditions and actually work better in very bright but chilly conditions. They can actually lessen production by a small amount if the temperature is too hot.

We would be able recommend a range of quality panels suited to your individual needs, based on output, budget, availability and how they will look on your property.

All of the panels we use will come with a minimum warranty of 20-25 years as do most panels, but not all 20 year warranties are the same. Some will only guarantee that they will work for 20 years, whereas the panels we install will also warranty high levels of output for that period too. Whilst you do not have to buy the most expensive panels to get a good warranty, the cheapest is seldom the best.

Solar systems have been installed across the world for may years, as we have mentioned above the panels last for a very long time and generally speaking the only other part that will need replacing in time is the inverter. These come with a range of warranties from 5-10 years as standard, but increasing the warranty to 20 years is often very inexpensive and can be extended in some cases for as little as £150.

This can vary with the type and size of installation, but on a general note, our team would complete both the roof works and the internal wiring in a day. The scaffold will usually go up the day before and potentially stay up for a few days whilst we ensure everything is working as we would expect, but from day 1 you will be generating energy.

Business Solar PV

We would love to talk to you more about solar panels, and the benefits they can have on your electricity bill, contact us today to get the best deals.
